Work updates

Update - 20 August 2024 - Halfpenny Bridge Repairs: Phase Two

The temporary traffic lights, as described below, have now been removed. Work is continuing, as pictured:

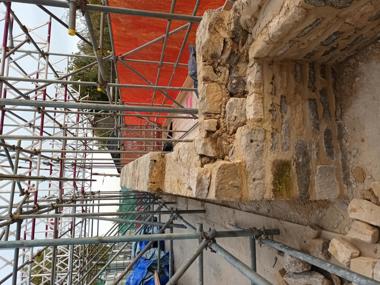

Photo of scaffolding on bridge

Update - 29 July 2024

The next phase of repairs will start during the week beginning 29 July. This phase of works is expected to last approximately two months. Work is expected to take place seven days per week, Monday - Sunday, between the hours of 7am - 7pm.

The road will remain open throughout these repairs, although temporary two-way traffic lights will be in operation. The public footpath (Thames National Trail) will remain closed throughout our repairs. The existing pedestrian diversion will remain in place.

What is being done to the bridge?

These repairs involve vegetation removal, re-stitching a crack in the south-eastern pedestrian arch, the partial dismantling/rebuilding of a wing wall and repairs to the nearby riverbank to prevent erosion.

Before any work commences, a thorough ecology check of the area will be undertaken. If any nesting birds, bats, newts or other protected species are found on site, all work will cease and advice will be sought from an ecologist.

Regarding the repairs themselves:

    • The tree growth, vegetation and stump growing through the south-eastern pedestrian arch will be removed to protect the structure and improve visibility.
    • Small trial holes (est. 300mm square) will be drilled near the corner of the south-eastern pedestrian arch, to determine the foundation depth of the structure. This will help us to better understand the extent of the cracking.
    • We will repoint the cracking with a NHL 3.5 mortar and inject a heritage grout into the void behind this crack.
    • Rather than taking down the entire parapet, it will be taken down only where there are defects/vegetation and rebuilt. Re-construction will be done using reclaimed original stone and the NHL 3.5 mortar.
    • The eroded riverbank will be reinstated to prevent further erosion. The riverbank will be filled with limestone boulders and gabion stone.

We have no intention of placing any pins/anchors through the voussoir (the ‘wedge’) of the pedestrian arch. The minor cracking at this location will therefore remain in place. However, this cracking will be monitored through regular inspections. Once our repairs are complete, the corner of the south-eastern pedestrian arch will also be monitored for any movement.

Which statutory bodies are involved?

Historic England

Halfpenny Bridge is a historic, Grade II listed structure. Any repairs therefore require consent from Historic England (H.E.). Following ongoing discussions with H.E., they have confirmed that permission will be awarded to Gloucestershire County Council in time for our current start date (Monday 22 July). Historic England had initially challenged our proposed method of repairing this structure, which led to design changes by Atkins. Our revised design has now been accepted.


The Environment Agency

With respect to the riverbank re-instatement works, permission is needed from the Environment Agency. The Environment Agency have now received our method statement, construction drawings and scaffolding design as requested. All fees have been paid and our application has been ‘duly made’. We are confident of permission being awarded to the council shortly.


Read about previous work updates below:

    • A structural inspection was undertaken of the bridge, from both the highway and from the river, from which it considered that there were no immediate concerns with arch relating from the accident damage to the parapet
    • The project team have reviewed the method of repair work and requirements for temporary works required to repair the parapet. In order to maximise the use of the closure on the highway, minor maintenance works were identified, which can be undertaken concurrently on the bridge in order to minimise future disruption at the bridge.
    • We have been working with all relevant legislative agencies, Historic England, Environment Agency along with the statutory undertakers and ecological specialists to ensure the correct measures and consents are in place to undertake the works safely
    • The project team have been working closely with stakeholder and partners to conclude the design requirements and construction methods in line with relevant standards and consents
    • GCC held a public consultation meeting on Thursday 20 July at Lechlade Memorial Hall. Our FAQs have been updated to reflect the comments and discussions from the meeting.

Diver in the water with equipment. Crane holding diving equipment needed to retrieve parts of the bridge from the water. View from the bridge of the crane grabbing something off the bridge, with a digger on the road. A diver entering the river and another worker holding on to the line that is connected to the diver. A picture of the equipment holding parts of the bridge that were in the water. A picture of the river from the bridge.

Diver in the water with equipment. Crane holding diving equipment needed to retrieve parts of the bridge from the water. View from the bridge of the crane grabbing something off the bridge, with a digger on the road. A diver entering the river and another worker holding on to the line that is connected to the diver. A picture of the equipment holding parts of the bridge that were in the water. A picture of the river from the bridge.

March 2024

We are currently planning phase two of the bridge repair work. This will involve the partial dismantling and rebuild of a wing wall and repairs to the archway and river embankment. The public footpath (Thames National Trail), will remain closed until completion of the work and the existing pedestrian diversion will remain. Gloucestershire County Council are working with our partners Atkins to complete the design work in consultation with the Environment Agency and Historic England. Early summer will likely provide the best conditions to carry out the repair work. It is anticipated the work will take ten weeks to complete. There will be no road closures for the work, however, traffic lights will be in operation for approximately two weeks of this time.


•    SBC footpath repairs (levelling and maintenance)
•    Completion of demobilisation – track mats & cabins removed
•    Reinstatement of field
•    Road reopen (Friday 03/11/23)


•    SBC footpath repairs (levelling and maintenance)
•    Completion of demobilisation – track mats & cabins removed
•    Reinstatement of field
•    Road reopen (Friday 03/11/23)

•    Parapet Repair completed
•    De-mobilisation from site initiated
•    Deconstruction of scaffold
•    Abutment Defect Optioneering
•    Set up dynamic monitoring of Abutment defect

•    Parapet Repair completed
•    De-mobilisation from site initiated
•    Deconstruction of scaffold
•    Abutment Defect Optioneering
•    Set up dynamic monitoring of Abutment defect

  • Parapet Repair continues
  • Abutment defect – feasibility/option discussions continue
  • Meetings/liaison with Environment Agency and Historic England continued
  • Parapet Repair continues
  • Abutment defect – feasibility/option discussions continue
  • Meetings/liaison with Environment Agency and Historic England continued
  • Parapet wall rebuild work ongoing
  • Parapet wall rebuild work ongoing
  • Scaffolding continues (delays due to high winds)
  • Removal and cleaning of damaged parapet section of wall
  • Stone masons crafting coping stones
  • Further assessment of subsurface defects - monitoring of towpath arch structure
  • Liaison with Environment Agency further site meeting with Historic England arranged w/c 2 Oct
  • Scaffolding continues (delays due to high winds)
  • Removal and cleaning of damaged parapet section of wall
  • Stone masons crafting coping stones
  • Further assessment of subsurface defects - monitoring of towpath arch structure
  • Liaison with Environment Agency further site meeting with Historic England arranged w/c 2 Oct
  • Stone retrieval from riverbed completed
  • Repairs to the stone archway progressing - significant subsurface defects encountered
  • Historic England site visit undertaken 14/09/23. Further site meeting to be arranged with Historic England’s structural engineer.
  • Monitoring points of crack in arch set up, to be inspected weekly
  • Stone retrieval from riverbed completed
  • Repairs to the stone archway progressing - significant subsurface defects encountered
  • Historic England site visit undertaken 14/09/23. Further site meeting to be arranged with Historic England’s structural engineer.
  • Monitoring points of crack in arch set up, to be inspected weekly
  • Repairs to the stone arch initiated – significant subsurface defects encountered
  • EA permits approved and received
  • Historic England liaison ongoing - site visit planned for 14/09/23
  • Specialists divers on site to undertake stone retrieval
  • Base scaffold erected
  • Repairs to the stone arch initiated – significant subsurface defects encountered
  • EA permits approved and received
  • Historic England liaison ongoing - site visit planned for 14/09/23
  • Specialists divers on site to undertake stone retrieval
  • Base scaffold erected
  • Pedestrian footpath has been closed and diverted
  • Repairs to the stone arch underway
  • Installation of barbed wire fencing to deter livestock
  • EA application has been duly made but awaiting formal completion and sign off
  • EA liaison for embankment reinstatement is ongoing
  • Historic England liaison ongoing. Site meeting arranged for Monday 4 September
  • In this clip from a staff meeting an overview of the week's work is given live from the site:



  • Pedestrian footpath has been closed and diverted
  • Repairs to the stone arch underway
  • Installation of barbed wire fencing to deter livestock
  • EA application has been duly made but awaiting formal completion and sign off
  • EA liaison for embankment reinstatement is ongoing
  • Historic England liaison ongoing. Site meeting arranged for Monday 4 September
  • In this clip from a staff meeting an overview of the week's work is given live from the site:



  • Compound set up completed, which included:
    - Erection of two gateways to maintain access
    - Assembly of 200m of Heras fencing to secure the compound
    - Installation of 280 trackway mats for site access and the compound
  • Installation of a welfare cabin and storage unit
  • Diving specialists underwater Inspection and initial assessment of stone to be recovered from the river
  • Environment Agency confirmation duly made for the scaffold and bridge repair element of the works. Further determination in progress for the embankment reinstatement works.
  • Environment Agency agreement for the embankment reinstatement, liaison ongoing
  • Liaison with Historic England ongoing
  • Compound set up completed, which included:
    - Erection of two gateways to maintain access
    - Assembly of 200m of Heras fencing to secure the compound
    - Installation of 280 trackway mats for site access and the compound
  • Installation of a welfare cabin and storage unit
  • Diving specialists underwater Inspection and initial assessment of stone to be recovered from the river
  • Environment Agency confirmation duly made for the scaffold and bridge repair element of the works. Further determination in progress for the embankment reinstatement works.
  • Environment Agency agreement for the embankment reinstatement, liaison ongoing
  • Liaison with Historic England ongoing
  • Discussions with Envrionment Agency ongoing – agreement to start onsite without permit in place
  • Historic England consent received
  • Legal agreement with landowners signed
  • Highway preparatory works started onsite
  • Vegetation Clearance Undertaken
  • Fencing erected
  • Discussions with Envrionment Agency ongoing – agreement to start onsite without permit in place
  • Historic England consent received
  • Legal agreement with landowners signed
  • Highway preparatory works started onsite
  • Vegetation Clearance Undertaken
  • Fencing erected
  • Design pack reviewed in detail by term maintenance contractor
  • UXO site inspection (incl. divers) 22 August
  • Risk assessments and method statements complied and circulated to stakeholders for agreement
  • Bespoke Environment Agency (EA) consent for cantilevered scaffolding to enable parapet repair required – discussions ongoing
  • EA support to start works for non-flood risk elements ahead of permit issue
  • Formal land agent engagement underway for site compound:
    - Provisional agreement for site access
    - Compound extents confirmed
    - Reinstatement specification agreed
    - Legal review of agreements underway – site access to be granted once agreement signed
  • Design pack reviewed in detail by term maintenance contractor
  • UXO site inspection (incl. divers) 22 August
  • Risk assessments and method statements complied and circulated to stakeholders for agreement
  • Bespoke Environment Agency (EA) consent for cantilevered scaffolding to enable parapet repair required – discussions ongoing
  • EA support to start works for non-flood risk elements ahead of permit issue
  • Formal land agent engagement underway for site compound:
    - Provisional agreement for site access
    - Compound extents confirmed
    - Reinstatement specification agreed
    - Legal review of agreements underway – site access to be granted once agreement signed
  • Initial design pack (inc. first draft drawings) handed to term maintenance contractor, Ringway
  • UXO survey ordered, desk top risk assessment underway – identification if physical surveys and/or watchman required
  • Internal risk assessments and method statements being reviewed to ensure they fully cover dealing with potential explosives/UXO’s
  • Invasive weeds highlighted within the site limits – process initiated to remove plants
  • Inspection of underwater site – order placed
  • Retrieval works – order placed
  • Environment Agency (EA) consent to start the footpath reinstatement work agreed, planning and liaison in progress
  • Bespoke EA permit likely required for parapet repair – discussions continue
  • Scaffold design expected by the end of 04/08/23
  • Land agent meeting scheduled to formalise site access, compound extents and reinstatement specification w/c 07/08/23
  • SSE to arrange further overhead cable protection – beyond current site extents
  • Works continue to advance and collate method statements for all aspects of site works
  • GCC continues work closely with Oxfordshire CC and Swindon BC to manage and improve the official diversion route and roads immediately around the closure. This work includes on-going engagement with local communities to understand the issues with traffic in the area
  • Initial design pack (inc. first draft drawings) handed to term maintenance contractor, Ringway
  • UXO survey ordered, desk top risk assessment underway – identification if physical surveys and/or watchman required
  • Internal risk assessments and method statements being reviewed to ensure they fully cover dealing with potential explosives/UXO’s
  • Invasive weeds highlighted within the site limits – process initiated to remove plants
  • Inspection of underwater site – order placed
  • Retrieval works – order placed
  • Environment Agency (EA) consent to start the footpath reinstatement work agreed, planning and liaison in progress
  • Bespoke EA permit likely required for parapet repair – discussions continue
  • Scaffold design expected by the end of 04/08/23
  • Land agent meeting scheduled to formalise site access, compound extents and reinstatement specification w/c 07/08/23
  • SSE to arrange further overhead cable protection – beyond current site extents
  • Works continue to advance and collate method statements for all aspects of site works
  • GCC continues work closely with Oxfordshire CC and Swindon BC to manage and improve the official diversion route and roads immediately around the closure. This work includes on-going engagement with local communities to understand the issues with traffic in the area
Last reviewed:
